Showing the 12-photo build sequence.

Site Setup & Kit Delivery
The installation area and delivered kit materials before structural assembly began.

Prefabricated Components
Factory-prepared timber components organized on site for assembly.

Floor & Wall Framing
Floor platforms and wall-frame sections prepared across the three cabin sites.

First A-Frame Raised

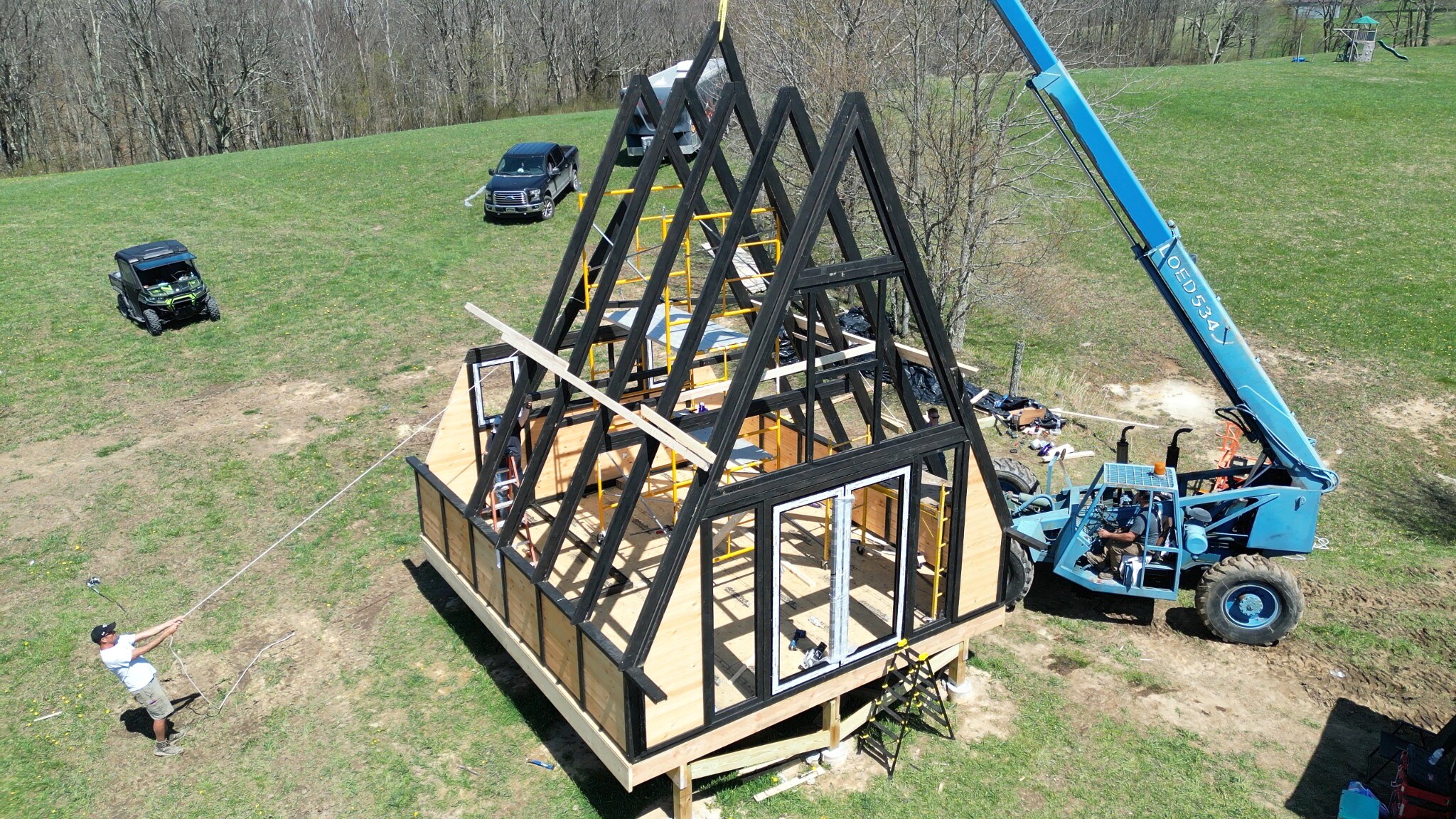

The first main A-frame section was lifted into position with site equipment.
Frame Installation
A closer view of the prefabricated frame sections being positioned and secured.

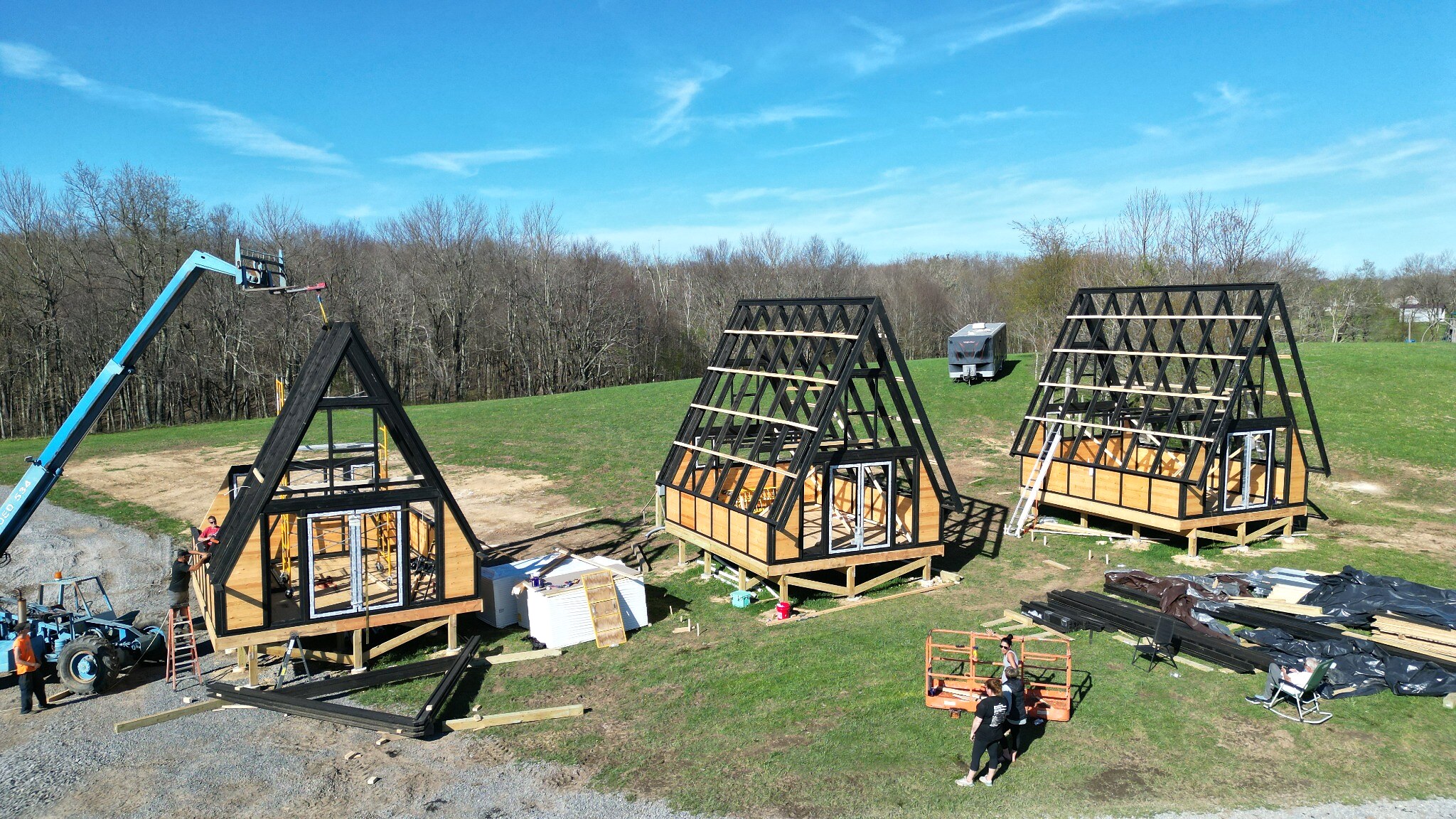

Framing Complete
The three primary A-frame structures standing together before roof enclosure.

Roof Insulation & Battens
Insulation, sheathing zones and timber battens visible before the final roof covering.

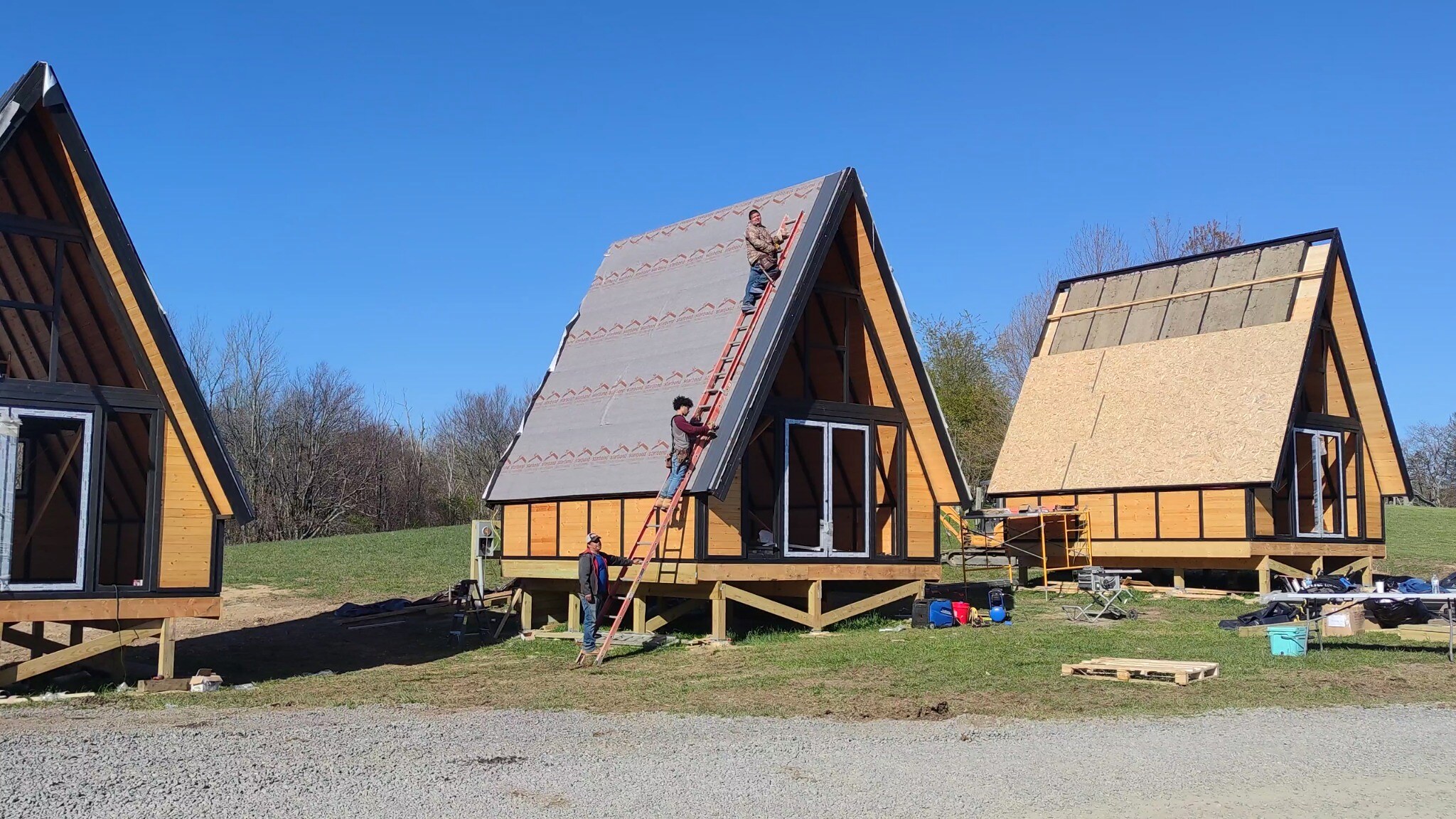

Roof Membrane & Insulation
Crew working across the roof membrane while adjacent cabins show other layer stages.

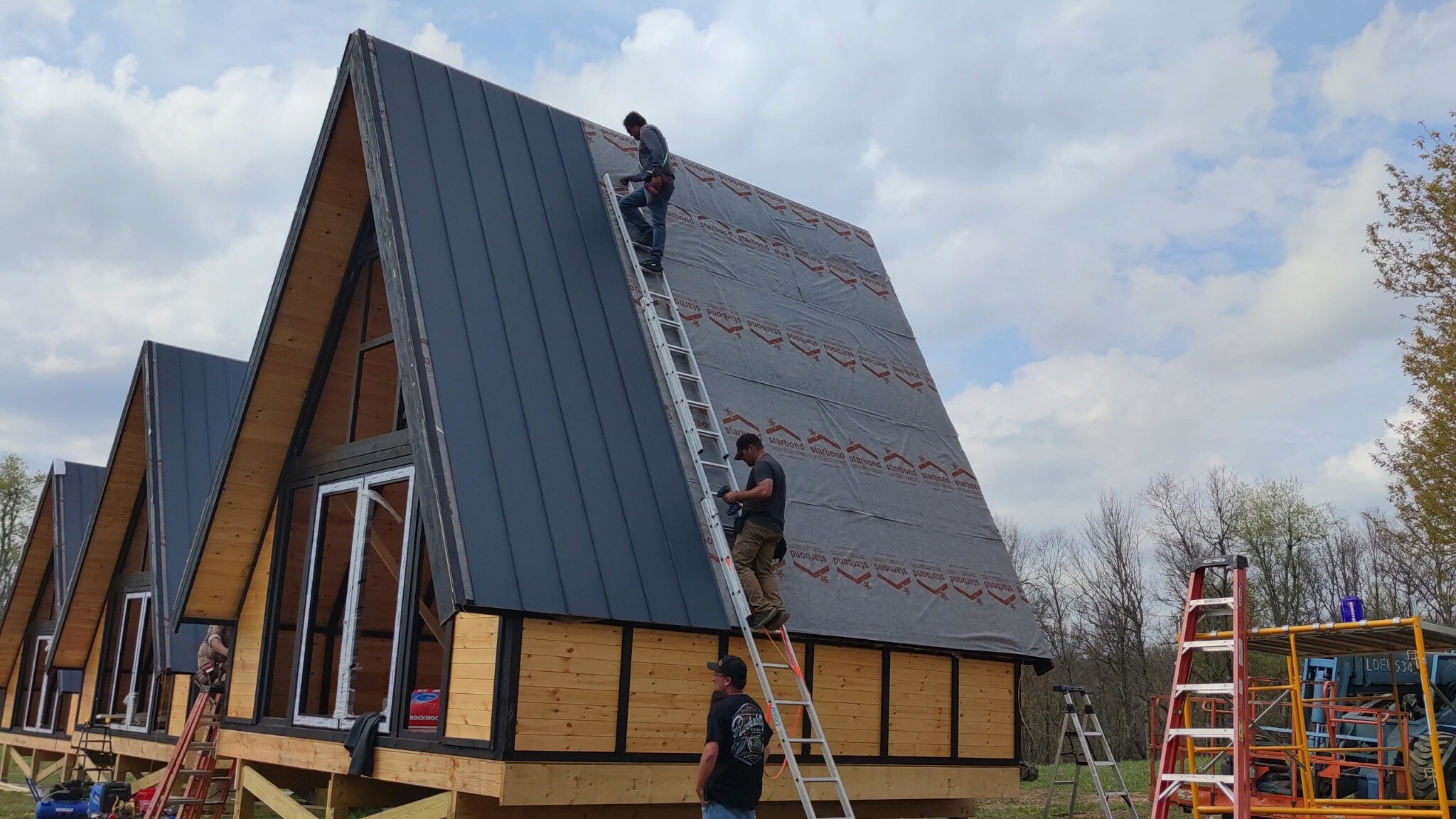

Standing-Seam Roofing Begins
Dark standing-seam metal panels installed progressively across the steep A-frame roof.

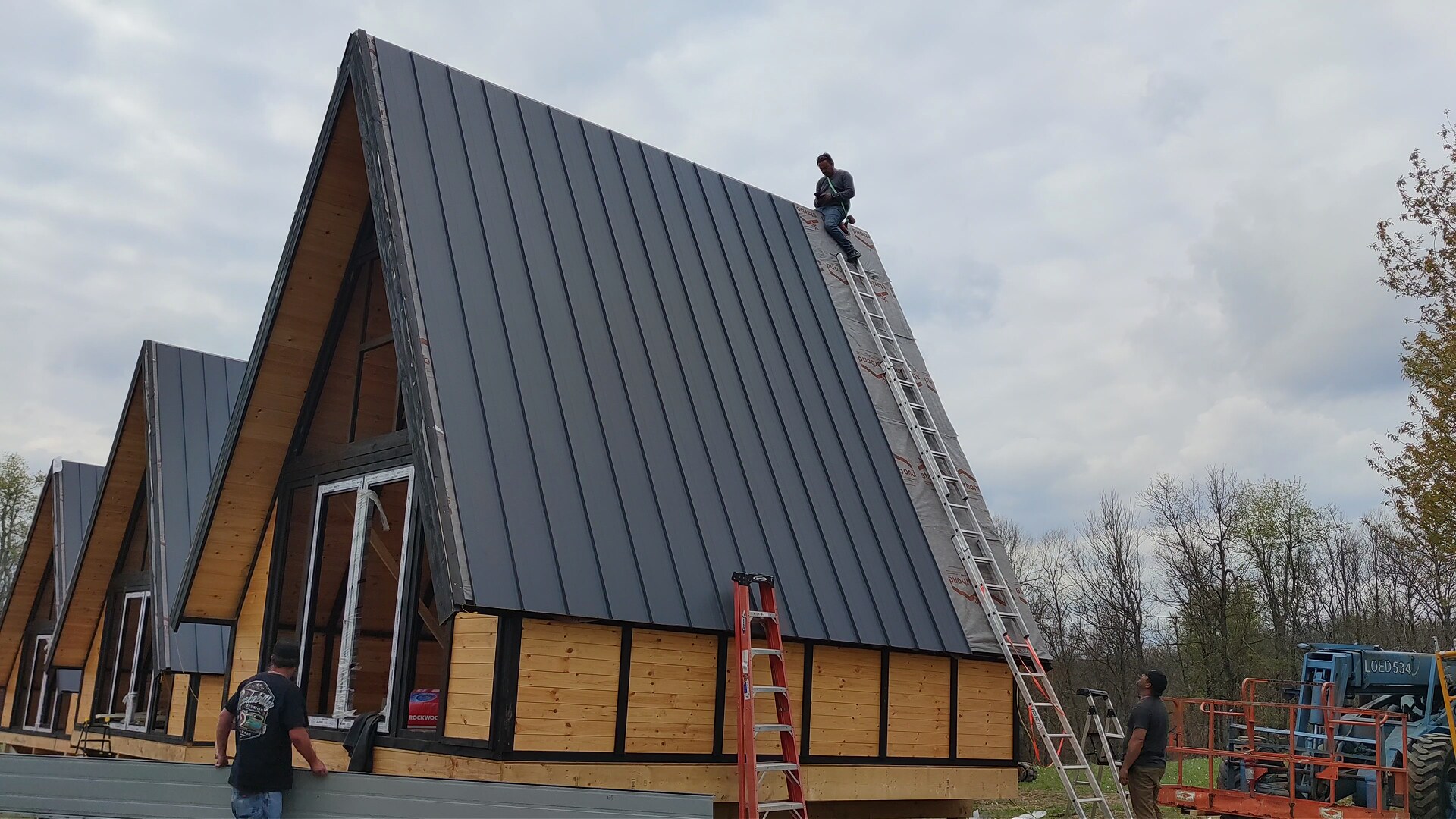

Standing-Seam Roof Completion
Final standing-seam panels and ridge work completed on the front cabin.

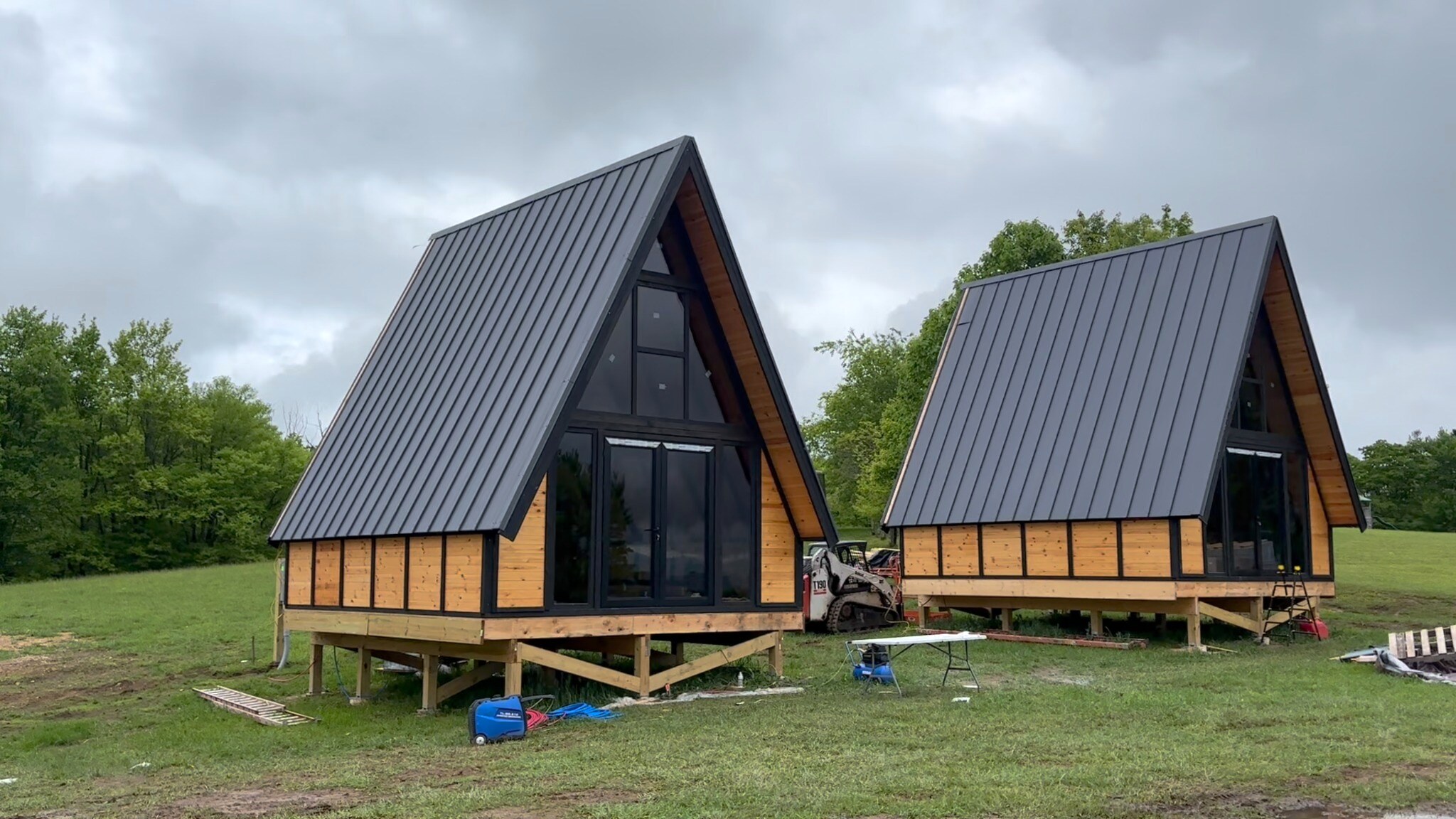

Front Glazing
Insulated front glazing and glazed doors installed as the cabin shells were enclosed.

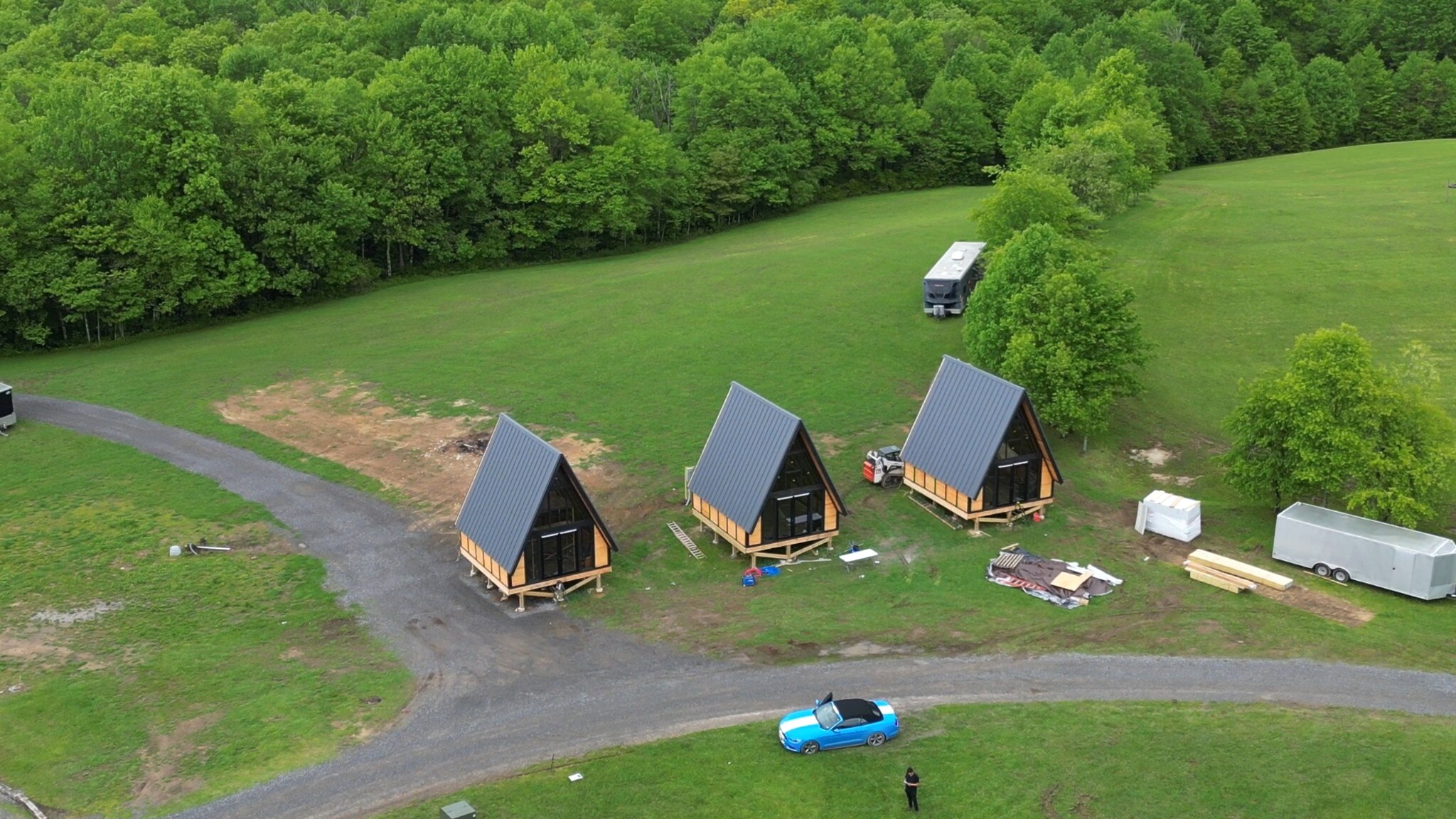

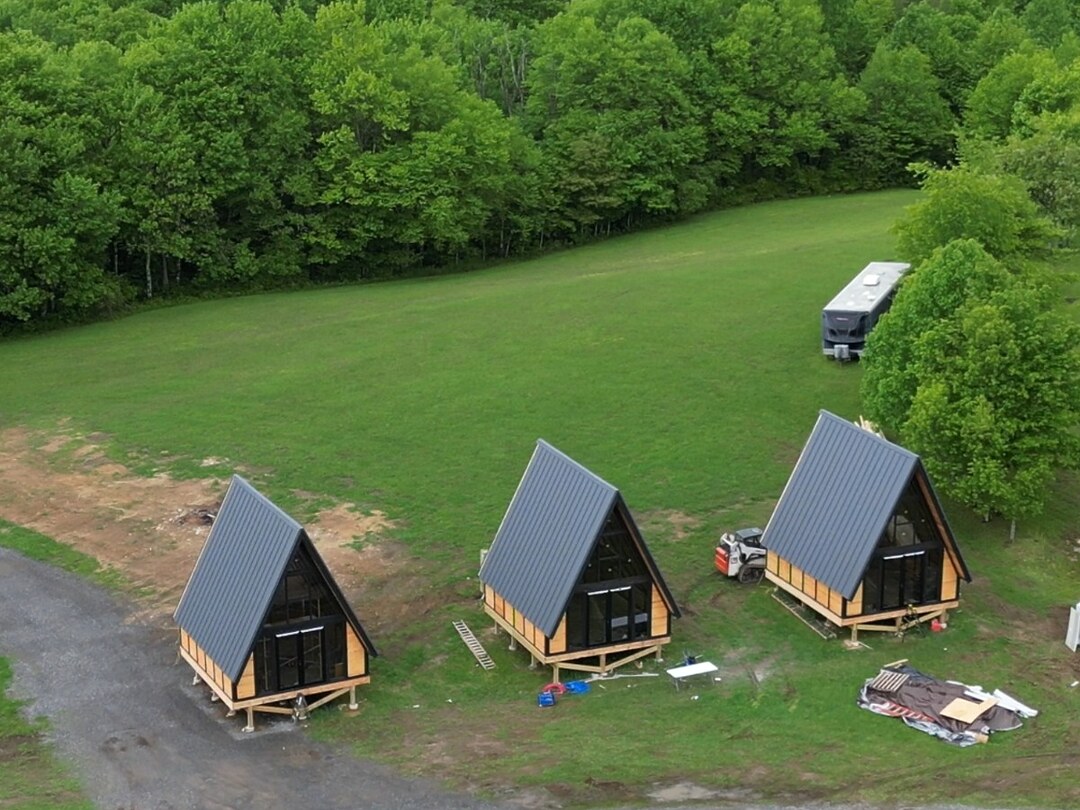

Core & Shell Complete
All three structural core-and-shell packages assembled before local finishing work.
