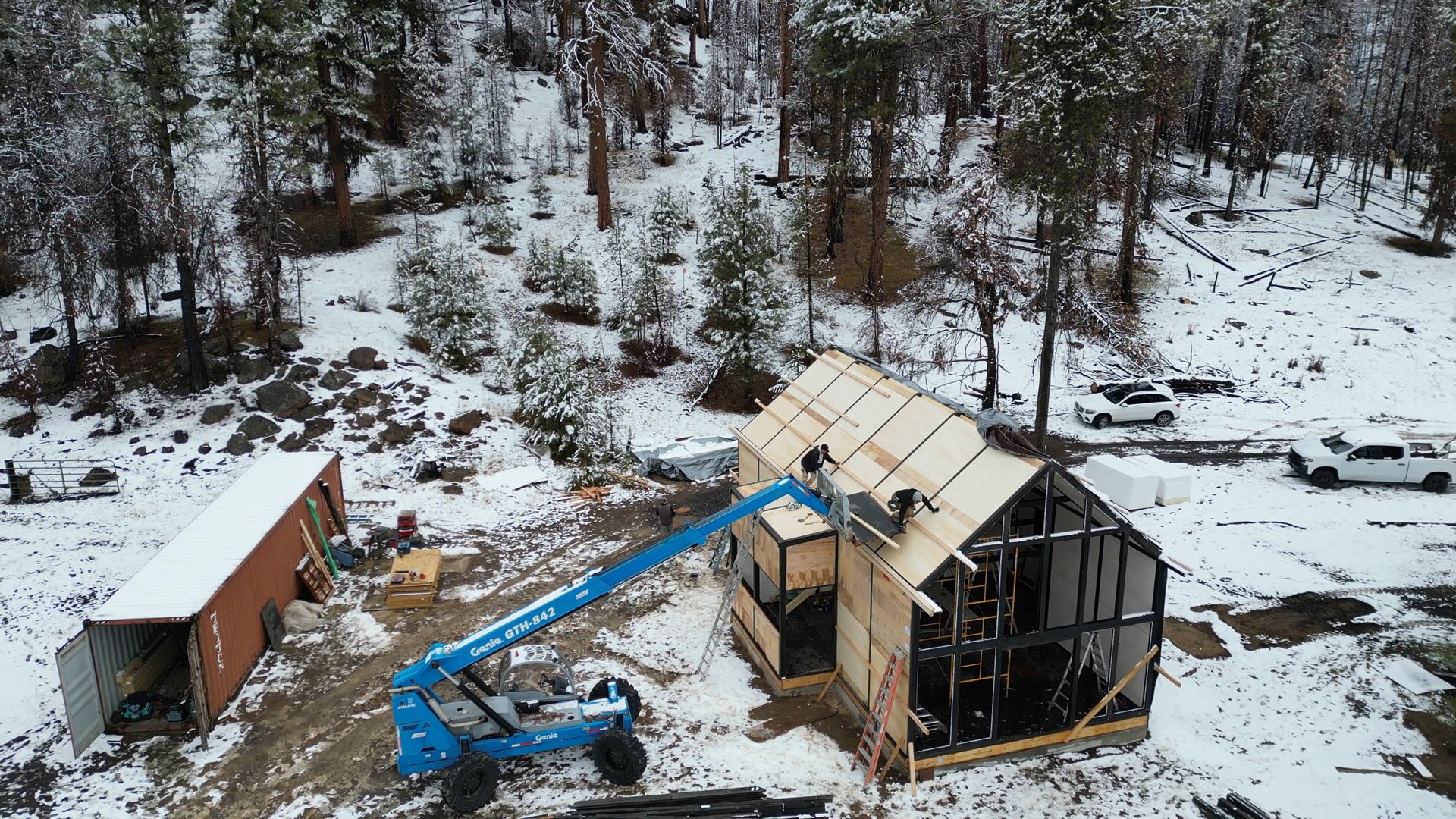

Cabin Kit Assembly Responsibility Guide
This article explains what SolidCabin supplies and which work remains with the local project team.
An imported cabin kit does not normally arrive with a foreign construction company that completes every stage of the project.
SolidCabin manufactures and exports the factory-prepared cabin package. A local construction team receives, assembles and completes the cabin at the project location.
The Short Answer
SolidCabin prepares the model-specific package and supplies production drawings, assembly documents and technical reference information for the supplied system.
The local team normally handles:
- Site preparation and foundations
- Receiving and unloading
- Structural assembly
- Roofing and weatherproofing
- Installation of factory-supplied glass when ordered
- Insulation installation
- Electrical, plumbing and HVAC
- Bathrooms, appliances and local finishes
- Inspections and local code compliance
- Site management and safety
1. SolidCabin's Factory Role
Depending on the confirmed scope, SolidCabin may:
- Prepare structural timber components
- Machine and identify model-specific parts
- Prepare wall, roof, partition, loft and stair components
- Supply joinery and ordered factory options
- Prepare production and assembly documentation
- Organize and protect packages for export
- Provide technical clarification for the supplied system
SolidCabin does not normally become the local general contractor for an exported cabin.
2. Who Can Assemble the Cabin?
The local assembly team may be:
- A general contractor
- A timber-framing contractor
- An experienced carpentry crew
- An owner-managed team using qualified trades
- A resort or developer's existing construction crew
The team should be comfortable reading construction, structural, assembly and site-specific permit documents.
3. Foundation and Site Work
The local project remains responsible for:
- Surveying and layout
- Excavation and drainage
- Foundation construction
- Anchoring and foundation interface
- Temporary access and staging
- Inspection of local work
The optional timber floor or crawl package is not the site foundation.
4. Receiving and Unloading
The local team must coordinate:
- Truck and container access
- Crane, telehandler or forklift
- Firm unloading area
- Material inventory
- Weather-protected storage
- Damage documentation
5. Structural Assembly
The structural crew positions, braces and connects the factory-prepared components according to the approved project information and assembly documents.
The crew remains responsible for:
- Field dimensions
- Temporary bracing
- Safe lifting
- Fastener installation
- Alignment and tolerances
- Weather protection during construction
6. Glass Installation
Window and exterior-door joinery is included unglazed in the standard kit.
Glass arrives only when the factory glass package has been ordered or expressly included in the quotation.
Installation of supplied glass is normally completed by the local team using the model-specific joinery details and appropriate glazing practices.
7. Insulation and Building Envelope
Insulation material is not included unless expressly listed in the quotation.
The local team must correctly install:
- Selected insulation
- Membranes and air-sealing layers
- Roof and wall ventilation details
- Flashings and sealants
- Local penetrations
8. Licensed Trades
Electrical, plumbing, HVAC and other regulated systems are normally completed by locally licensed trades.
They should review the cabin layout and structural routes early enough to avoid unnecessary cutting or rework.
9. Bathrooms, Kitchens and Local Finishes
Bathroom waterproofing, sanitary fixtures, plumbing connections, appliances and most decorative finishes remain local unless expressly included.
Optional kitchen cabinetry does not mean that appliances, electrical connections, plumbing or every countertop detail are included.
10. What Is SolidCabin Assembly Guidance?
SolidCabin can provide remote technical support for the supplied system.
Initial on-site assembly guidance may be separately agreed for suitable projects.
Guidance may include:
- Pre-construction document review
- Assembly-sequence explanation
- Component identification
- Connection-detail clarification
- Answers to contractor questions
- Review of site photographs
This is technical guidance only. It does not include local labor, general contracting, site management, equipment operation or responsibility for site safety.
11. Who Is Responsible for Code Compliance?
The appointed local professionals and contractors remain responsible for:
- Building according to approved local documents
- Local code compliance
- Required inspections
- Licensed work
- Temporary works and construction safety
- Site-specific methods and sequencing
